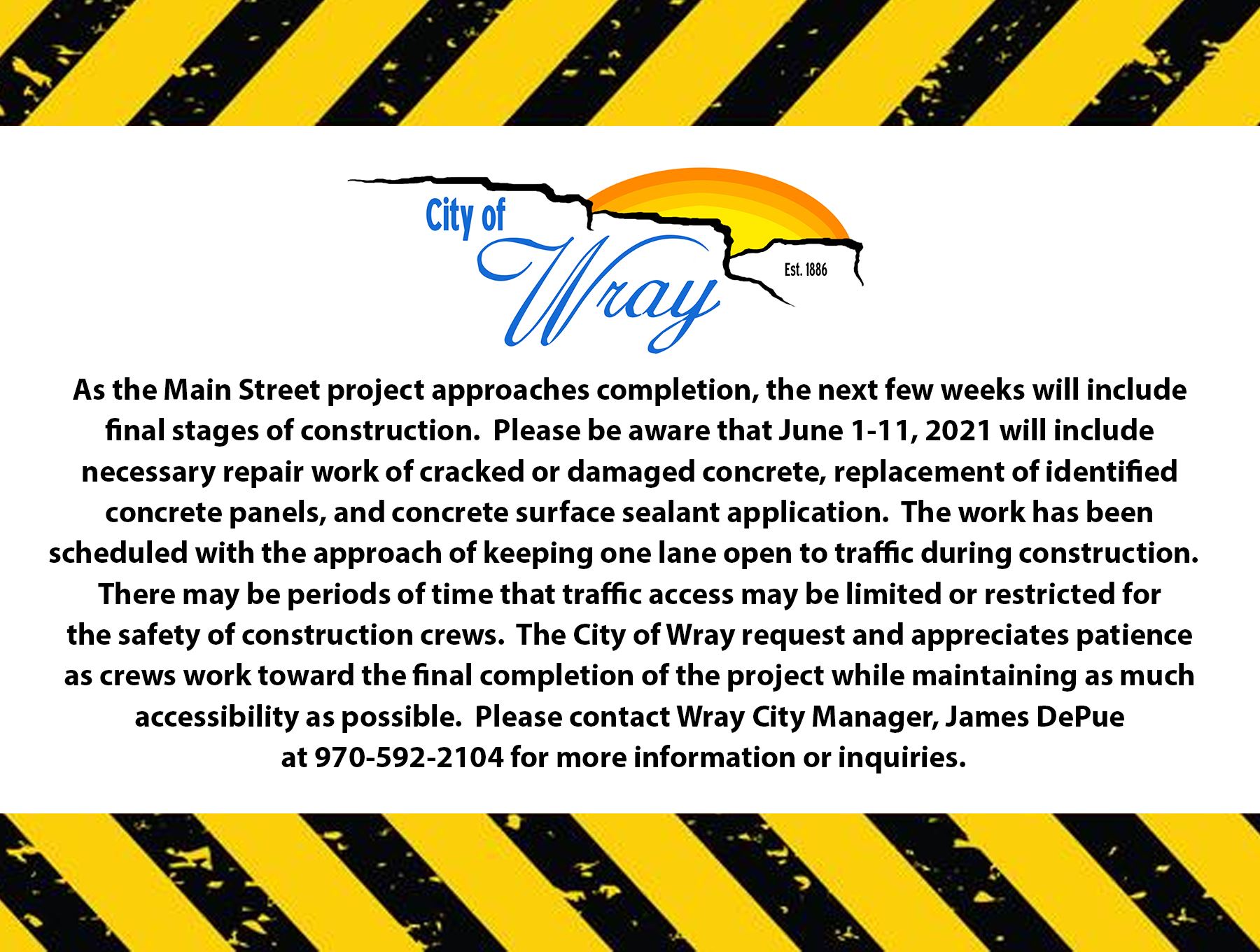

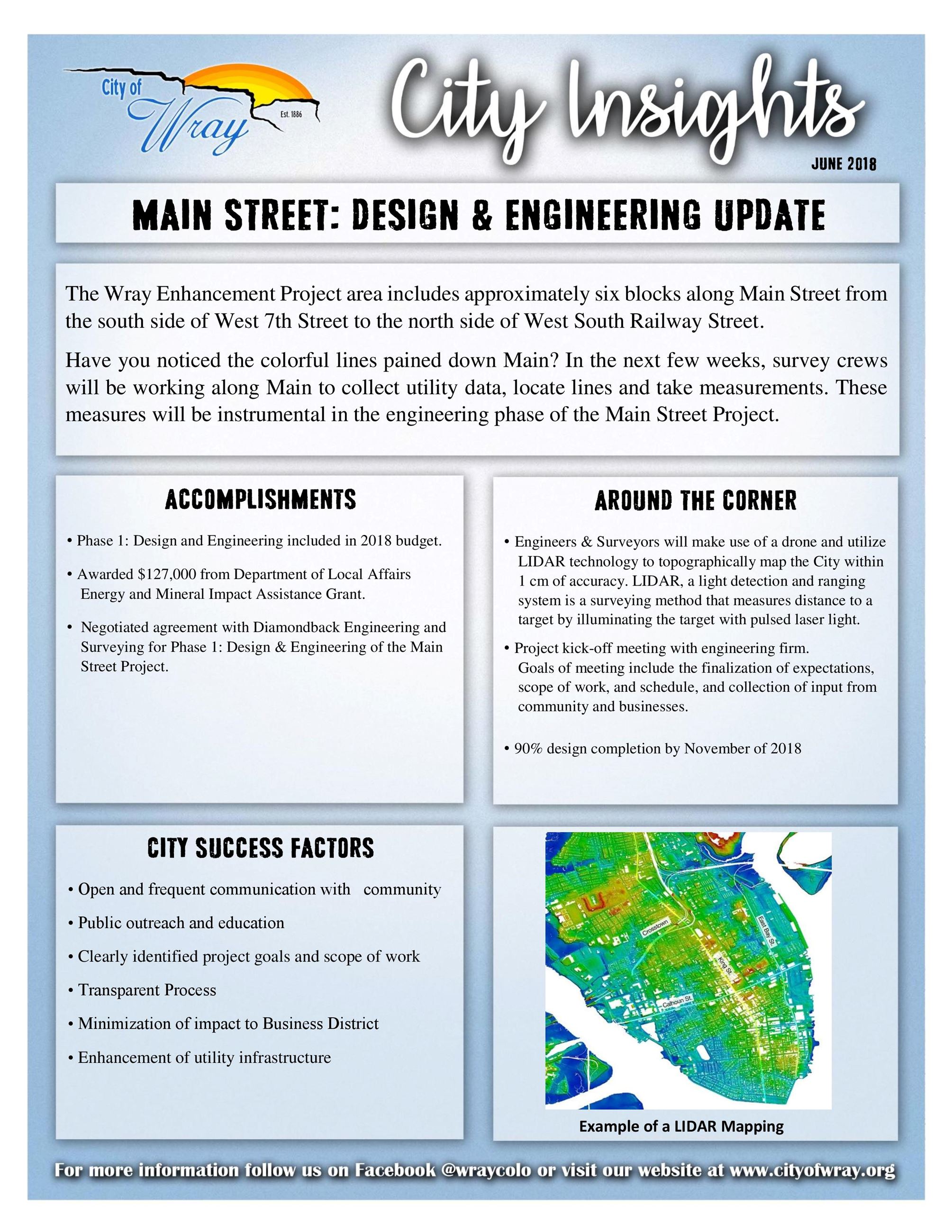

Project Timeline
Project time line is approximate and subject to change.
Phase 1 | HWY 34 to 4th Street | 8/10/2020 - 10/30/2020 |
Phase 2 | 4th Street to 5th Street | 10/2/2020 - 12/1/2020 |
Phase 3 | 5th Street to 7th Street | 10/23/2020 - 12/31/2021 |
Phase 4 | Railway Street to HWY 34 | 12/3/2020 - 2/10/2021 |
Bridge 1 | Mill Race Bridge Removal | 9/8/2020 - 9/29/2020 |
Bridge 2 | Republican River Bridge Replacement | 9/30/2020 - 12/17/2020 |
Important Dates
- Notice of Award – July 15, 2020
- Preconstruction Meeting—July 28, 2020
- Notice to Proceed – August 3, 2020

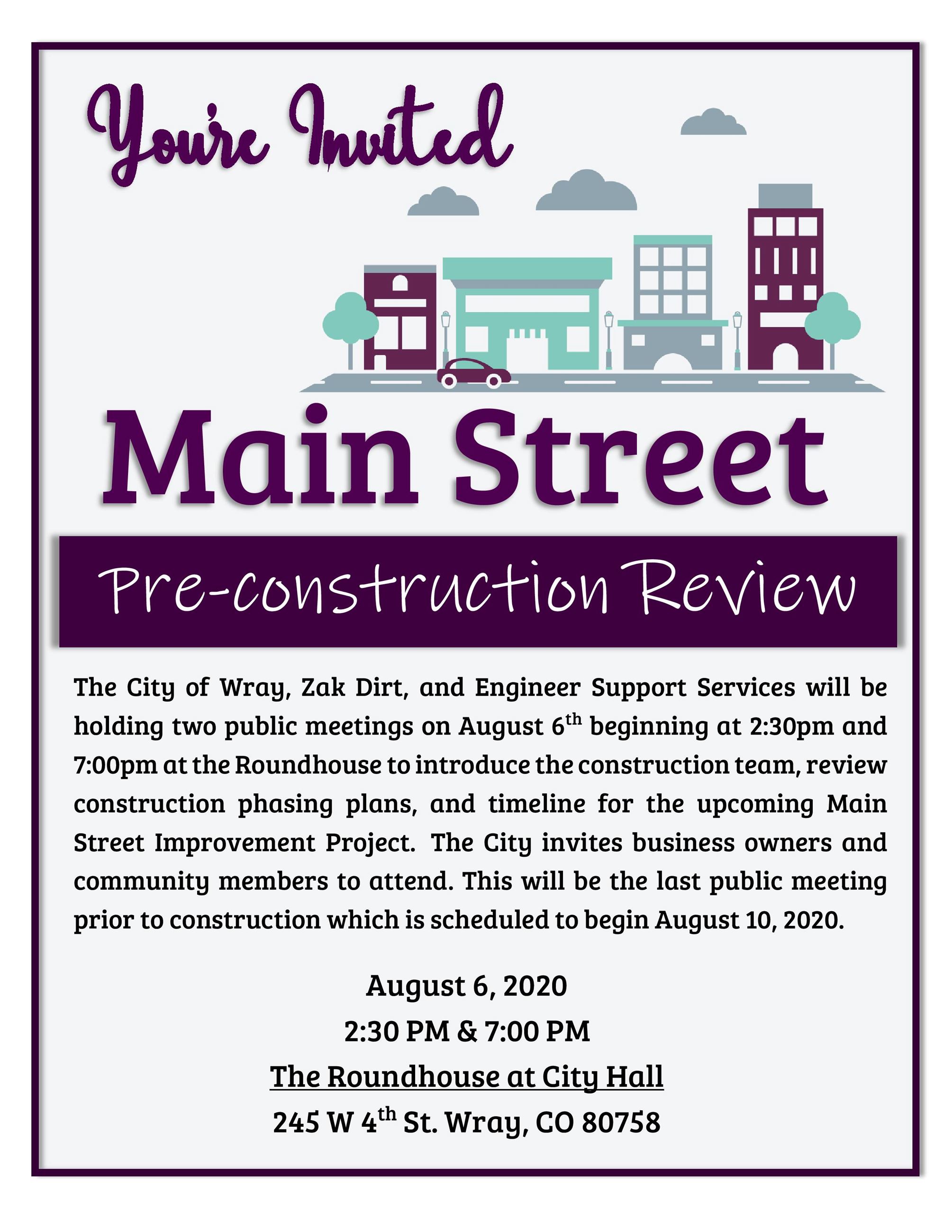

- Pre-construction Review (Public Meeting) – August 6, 2020
- Construction Begins – August 10, 2020
- 240 Day Total Construction Timeline
